Directional Well Drilling Project Update – April 14, 2004
The second phase of the directional water well project continues in CPN. The directional well is located north of Coyote Ridge Park, and will connect to the vertical well that was recently drilled near Hidden Pointe Blvd. and Monarch Blvd.

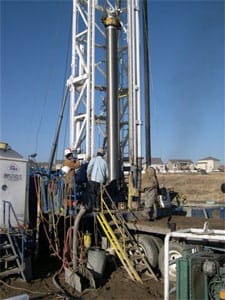

Dirt work and surface casing required for the directional well was completed the first week of April. Mobilization of the directional well site and drilling began on April 5th.
By utilizing this innovative technology, the Metro District hopes to reduce the cost of drilling additional vertical wells to meet the supply needs of our community.
If you would like to schedule a site tour of this innovative project, or for more information, please contact Judy Dahl at the Castle Pines North Metro District at 303-660-5880, ext. 11.
The Metro District will add 10 additional pet litter clean-up stations to the CPN trails this spring. Pet owners are asked to clean up after their dogs and remember to keep dogs leashed at all times when using the trails and open spaces.
The directional well is located north of Coyote Ridge Park, and will connect to the vertical well that was recently drilled near Hidden Pointe Blvd. and Monarch Blvd.
If you would like to schedule a site tour of this innovative project, or for more information, please contact Judy Dahl at the Castle Pines North Metro District at 303-660-5880, ext. 11.
Previous updates
3-12-2004 – Drilling for the vertical portion of the directional water well was completed on March 3rd.
Construction of the vertical well began on March 4th, and the site clean up is expected to be completed this week.
Mobilization for the directional well is scheduled to begin on March 29th. Drilling of the directional well, which will be located in the open space north of Coyote Ridge Park, is expected to begin on April 1st.
Upon completion, the directional segment of the well is designed to connect to the vertical segment of the well at the bottom of the aquifer. Directional well technology is expected to increase production rates from a traditional single vertical well.
Please contact Castle Pines North Metro District Manager Judy Dahl at 303-688-8550, ext. 11, or at judy@cpnmd.org, for more information about this project.
2-17-2004 – On Thursday, February 5th, Beylik Drilling, Inc., began drilling the vertical section of the directional water well project located at Monarch Blvd., and Hidden Pointe Blvd.
As of February 13th, the total depth drilled is 1,150 feet. The drilling of the vertical portion of the well will take approximately two more weeks. Then, the well will be constructed and developed. Upon completion of the vertical well, drilling for the directional well will begin in the open space north of Coyote Ridge Park.
For additional information, or to schedule a tour of the site, please contact Judy Dahl at the Castle Pines North Metro District at 303-688-8550, ext. 11, or via e-mail at
judy@cpnmd.org.
Directional Well Drilling Schedule of Events
February 5
Drilling of vertical well begins, 24-hours-a-day, seven days-a-week, at the southeast corner of Hidden Point and Monarch Blvds.
February 20
Projected completion date of vertical well drilling.
February 22
Begin construction of directional well, located north of Coyote Ridge Park.
March 22, 2004
The second phase of the directional water well project is underway in Castle Pines North.
Minor permit delays have extended the project schedule; however, dirt work required for the directional well will be completed within two weeks. Mobilization to the well site begins on April 5th, and drilling of the well is expected to begin in mid-April.
